The Complete Office Move Checklist for 2026: 10-Phase Timeline + Free Template
Office moves cost the average mid-sized company between $1,000 and $7,000 per employee, take six to twelve months of planning to execute well, and produce a measurable productivity dip in the weeks before and after move day (IFMA, JLL workplace surveys 2024 to 2026). For workplace and facilities leaders, the difference between a smooth move and a chaotic one is almost entirely down to the checklist. Companies that work from a detailed, timeline-based checklist consistently come in on budget, on schedule, and with their teams intact. Companies that wing it almost always overspend, miss key vendor lead times, and bleed productivity for weeks.
This guide is the complete office move checklist for 2026. It covers every phase of a commercial office relocation from 12 months out to 30 days after move day, with concrete checklist items at each stage, cross-cutting guidance by topic (budget, technology, HR, vendors, legal), common mistakes to avoid, post-move best practices, and a downloadable Google Sheets template you can copy and adapt for your own move. Whether you are moving 20 people across town or 5,000 people across the country, the checklist below is the one your facilities team should be working from.
Office Moves in 2026: by the Numbers
| Stat | Figure | Source |
|---|---|---|
| Typical office move cost per employee | $1,000 to $7,000 | IFMA, JLL, commercial mover benchmarks |
| Typical office move budget (mid-sized firm, 100–500 staff) | $250,000 to $2 million | Industry benchmarks |
| Recommended planning lead time | 6 to 12 months | IFMA, BOMA best practice |
| Typical productivity dip before and after move day | 10 to 20% for 2–4 weeks | Industry surveys |
| Average asset attrition during office moves without active tracking | 5 to 10% of inventory value | Asset Management Institute benchmarks |
| Office moves that come in over budget without a checklist | 60%+ | Industry surveys |
| Lead time for commercial movers in peak season (Q2–Q3) | 8 to 12 weeks | Commercial mover networks |
Office Move Timeline at a Glance
A well-run commercial office relocation follows 10 distinct phases. The further out you start, the more options and the less stress at each step. Below is the high-level timeline. The next 10 sections each break down a single phase with detailed, bulleted action items.
| Phase | Timing | Focus |
|---|---|---|
| 1 | 12+ months before | Strategic decisions, lease review, broker engagement |
| 2 | 6 to 12 months before | New office selection, design, budget approval |
| 3 | 3 to 6 months before | Vendor selection, internal team formation, communications plan |
| 4 | 1 to 3 months before | Detailed planning, IT and infrastructure, employee communications |
| 5 | 2 to 4 weeks before | Inventory, packing preparation, address changes |
| 6 | 1 week before | Final logistics, contingency planning |
| 7 | Moving day | Execution and oversight |
| 8 | Day after | Initial setup, immediate issues |
| 9 | First week | Settling in, employee support |
| 10 | 30 days after | Decommissioning of old space, lessons learned |
12 Months or More Before the Move
The earliest phase. Most decisions made here are strategic and irreversible. Do not skip this phase even if your move is “only six months away”. You can compress the work, but you cannot eliminate it.
Strategic and lease decisions
☐ Confirm the reason and scope of the move. Growth, hybrid right-sizing, lease expiry, cost reduction, brand repositioning, consolidation of multiple offices. The reason drives every downstream decision.
☐ Review your current lease in detail. Identify the exact lease end date, renewal clause, early-termination penalty, restoration obligations (the condition you must leave the space in), and any holdover fees if you stay past the lease end.
☐ Calculate the cost of staying. Including the next lease term cost, anticipated rent increases, capex requirements, and operating expense reconciliations.
☐ Engage a commercial real-estate broker. A broker pays for themselves in negotiation alone. For mid-sized firms, get three broker proposals before selecting one.
☐ Define your space requirements. Desk-to-employee ratio (most hybrid offices run 0.5 to 0.7), meeting room types and counts, collaboration zones, phone booths, lab or specialized space, parking.
☐ Identify any non-negotiable location constraints. Maximum commute distance for retained staff, proximity to clients, public-transit access, parking ratio, building class requirements.
Stakeholder alignment
☐ Brief the executive sponsor. Confirm who in the leadership team owns the move and what their decision rights are.
☐ Form a steering committee. CEO or COO, CFO (for budget approval), HR head (for people impact), facilities lead, IT lead, legal counsel. Set a recurring meeting cadence.
☐ Run a confidential employee impact assessment. How many staff currently commute from where, how the new location would affect retention, what accommodations may be needed.
6 to 12 Months Before the Move
Major selections happen here: the new office, the move budget, the design direction, and the broad communications plan.
Real estate
☐ Tour shortlisted properties with the broker. Aim for 3 to 5 finalists with detailed floor plans and operating-expense data for each.
☐ Conduct a workplace strategy assessment. Survey employees on how they want to work, model the desk-to-employee ratio against expected attendance, decide on hybrid policy if not already set.
☐ Negotiate and sign the new lease. Include build-out allowance (TI), free-rent period, expansion rights, sub-let rights, restoration obligations, and HVAC after-hours rates.
☐ Negotiate the exit of your current lease. Restoration costs, return condition, security deposit return, holdover terms.
☐ Confirm permitted use and any zoning constraints for the new space.
Budget
☐ Build the move budget. Major line items: real estate (rent, deposit, broker fees), build-out (architect, contractor, furniture, fixtures, equipment), IT (network, phones, security), moving (movers, packing, insurance), HR (announcements, accommodations, transition support), legal (lease, permits), contingency (10-15% of total).
☐ Get CFO approval and a budget code. Every subsequent decision should reference the approved budget.
☐ Identify cost-saving opportunities. Reusing furniture, donating rather than disposing, leveraging contractor relationships, timing the move to avoid peak season.
Design and planning
☐ Engage a workplace designer or architect. They should have commercial office experience and references you can call.
☐ Develop test fits and design options. Two or three options that show different layouts within the new space.
☐ Get the design approved by the steering committee before construction documents are finalized.
Communications
☐ Develop a high-level communications plan. Who learns what, when, and how. Most organizations announce internally before externally.
☐ Plan the first all-hands announcement. Reason for the move, new location, timeline, and what will change for employees. Be specific about commute impact.
3 to 6 Months Before the Move
Vendor selection, detailed planning, and the formal kickoff of the internal move team.
Vendor selection
☐ Request quotes from at least three commercial moving companies. Specialists in commercial office moves, not residential. Check insurance coverage and references.
☐ Confirm moving insurance coverage. Industry standard is $0.60 per pound, which is wildly insufficient for office equipment. Buy supplemental coverage for high-value items.
☐ Select and contract the moving company. Lock in the date in writing.
☐ Engage IT vendors for the new office. Internet service provider, phone system, AV installation, security and badge access, structured cabling.
☐ Engage furniture vendors. Lead times for office furniture commonly run 8 to 16 weeks. Order what you need early.
☐ Engage decommissioning vendors for the old space. Cleaning, repair, lock change, equipment removal.
☐ Engage any specialty vendors. AV integrators, security consultants, signage, branding, art and plants.
Internal team and project management
☐ Form the move team or move committee. Project lead, IT lead, facilities lead, HR lead, communications lead, finance partner, departmental representatives.
☐ Build the master project plan. Use a project management tool with dependencies, owners, and dates.
☐ Set up the recurring project meeting. Weekly is typical at this stage.
Communications
☐ Send the formal internal announcement if not already done.
☐ Brief external stakeholders confidentially: key clients, suppliers, business partners, building service providers.
☐ Plan the visitor communications: signage at the old office for visitors arriving after the move, redirected phone lines, updated website.
1 to 3 Months Before the Move
The detailed planning phase. Most of the move team’s heaviest work happens here.
Logistics and infrastructure
☐ Finalize the new office floor plan. Where every desk, room, meeting space, storage area, kitchen, and printer goes.
☐ Plan ethernet, power, and AV requirements at every workstation and meeting room.
☐ Schedule construction completion before move-in. Build in buffer time, because construction always overruns.
☐ Schedule pre-move cleaning of the new space.
☐ Coordinate building access at both locations: elevator reservations, loading dock booking, off-hours move permission, parking for movers.
☐ Order new signage for the new office: exterior signs, lobby signs, way-finding, room signs, meeting-room displays.
Technology
☐ Plan IT migration in detail. Servers, network gear, end-user devices, software licenses, cloud connectivity, security.
☐ Confirm internet activation date. Internet provisioning commonly takes 30 to 90 days. Confirm activation will be live before move day, not after.
☐ Set up the new network infrastructure: cabling, switches, wifi access points, security and access control.
☐ Plan phone system migration. Number porting, voicemail, call routing.
☐ Plan AV setup for meeting rooms: displays, video-conferencing systems (Zoom Rooms, MS Teams Rooms), room scheduling integration.
☐ Set up the desk-booking, room-scheduling, and visitor-management platforms for the new office. The office move is the natural moment to install these from day one. DeskFlex deploys both in 4-6 weeks for typical mid-sized offices.
People and HR
☐ Detailed communication to employees. Send the moving timeline, the new floor plan, FAQs, and a clear point of contact for questions.
☐ Plan transit and parking communications. New address, transit routes, parking arrangements, secure bike parking.
☐ Run the office tour and orientation plan. Offer pre-move tours to employees who want them.
☐ Plan accommodations for employees with significant commute impact: transit subsidies, work-from-home options, transition support.
☐ Plan the move-day team: who will be on site at the old office, who at the new office, who is on call.
Inventory and assets
☐ Inventory every office asset. Furniture, IT equipment, kitchen equipment, AV systems, art, plants, soft assets. Tag each item that is being moved. (This is the time to set up asset management if you do not already have it. Office moves are the single biggest source of asset attrition.)
☐ Identify what to move, sell, donate, or dispose of. Most companies move too much. Be aggressive about what stays behind.
☐ Arrange disposal or donation of unwanted items. Donation typically generates a tax deduction; disposal is a cost.
☐ Plan secure destruction of confidential paper documents and decommissioned IT.
Legal and admin
☐ Review and renew business insurance for the new location.
☐ Update workers compensation coverage for the new address.
☐ Notify regulators or licensing bodies as required by your industry (healthcare, finance, government contracting, etc.).
☐ Update permits. Building permits, occupancy permits, signage permits, fire-safety certifications.
The Final Weeks
2 to 4 Weeks Before
☐ Send the formal address-change communications externally. Clients, vendors, suppliers, partners.
☐ Update your address everywhere. Website, Google Business Profile, Yelp, Facebook, LinkedIn, Crunchbase, Glassdoor, all business directories, business cards, email signatures, invoices, contracts, banks, insurance providers, payroll providers, mailing list providers.
☐ Order moving supplies. Boxes, packing tape, labels, color-coded stickers for departments, markers.
☐ Brief employees on personal packing expectations. What they pack, what stays for the movers, what they take home in advance.
☐ Conduct a pre-move walkthrough of both spaces with the moving company.
☐ Schedule the IT cutover with detailed timing.
☐ Confirm move-day logistics with every vendor.
☐ Set up the new office’s day-one essentials: internet active, phones working, key spaces accessible, basic supplies stocked.
1 Week before
☐ Final walkthrough with the moving company. Walk the route, confirm access points, identify any last-minute issues.
☐ Begin packing non-essentials. Files, books, supplies, art, decorative items.
☐ Distribute color-coded labels to every department.
☐ Collect all spare keys, badges, and access cards from departing tenants of the new space.
☐ Set up moving-day signage at both locations.
☐ Brief the move-day team on roles and responsibilities.
☐ Prepare a moving-day essentials box. Tools, charging cables, first aid, basic stationery, snacks, water, toilet paper.
☐ Confirm the move-day timeline with every vendor and key stakeholder.
☐ Back up all critical IT systems before any equipment is moved.
Moving Day
The day itself. If the planning has been good, moving day is more about oversight than action.
At the Old Office
☐ Move-day team on site early before the moving crew arrives.
☐ Brief the moving crew on priorities, fragile items, and special handling.
☐ Supervise loading. Use the inventory list to check off each item or container as it leaves.
☐ Conduct a final walkthrough of every room, including under desks, in cabinets, and in storage areas.
☐ Photograph every room after final clear-out. Evidence of condition at handover.
☐ Lock up and hand over keys to the landlord or property manager.
At the New Office
☐ Move-day team on site to receive the delivery.
☐ Supervise unloading. Check off each item against the inventory list as it arrives.
☐ Direct movers to the correct rooms using floor-plan signage and color codes.
☐ Test internet, phones, and core IT systems as early in the day as possible. Catch failures while vendors are still available.
☐ Identify any damaged or missing items immediately and document them with photographs.
☐ Conduct a basic safety walkthrough. Exits clear, fire extinguishers accessible, emergency lighting functional.
☐ Confirm AV and meeting-room equipment is functional in at least the rooms that will be needed first thing the next morning.
☐ Set up day-one essentials: coffee, water, restroom supplies, basic stationery, signage explaining where things are.

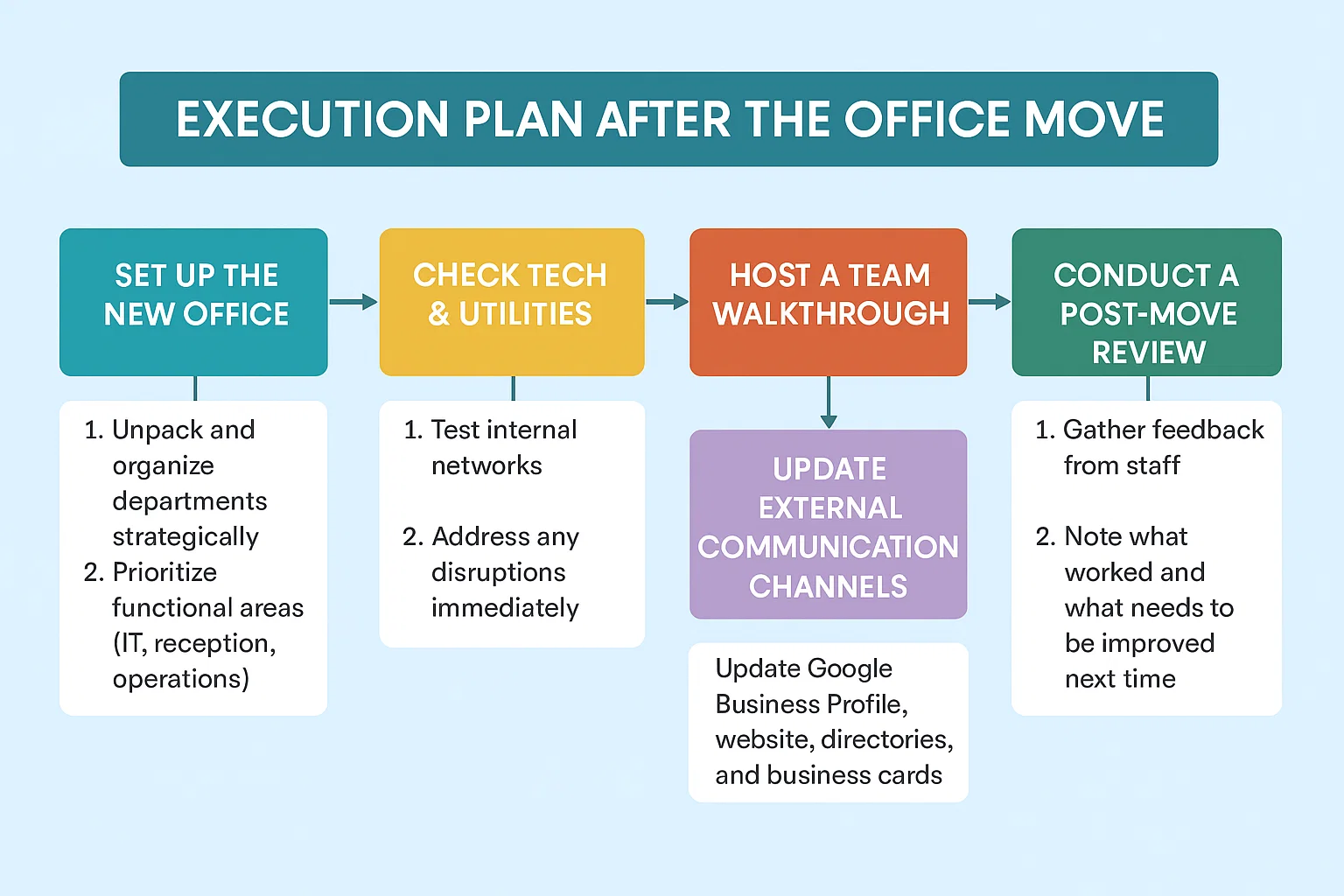

Post-Move Tasks
The work is not done at the end of move day. The next 30 days are when most companies either consolidate the win or let the momentum unravel.
Day After Move Day
☐ All-hands welcome. Brief everyone on the new office, where things are, who to contact for what.
☐ Quick first-day assessment. Walk the office with the move team, capture every issue raised, prioritize fixes.
☐ Verify IT systems are stable. Internet, phones, video-conferencing, file shares, security access, printers.
☐ Set up the help-desk channel for move-related issues. Slack, Teams, email, ticket queue, whatever works.
☐ Provide tours to anyone who wants one. Designate a few people who can answer where-is-X questions.
First Week
☐ Daily issue review. What broke, what was missing, what needs adjusting.
☐ Run a fire drill or emergency-procedure briefing. New building, new exits, new assembly points.
☐ Brief everyone on building security, access cards, visitor procedures.
☐ Set up the visitor management system for the new lobby. Day-one visitor experience matters. DeskFlex’s visitor management is built for this.
☐ Activate desk booking and room scheduling for the new office. The move is the perfect moment to roll out hoteling if you are going hybrid.
☐ Survey employees for first-impression feedback. Anonymous, short, actionable.
30 Days After
☐ Decommission the old office completely. Final cleaning, repairs, restoration, key return, lease close-out, security deposit recovery.
☐ Settle outstanding invoices from movers, vendors, contractors.
☐ Run the post-move review with the move team. What worked, what did not, what would you do differently.
☐ Reconcile the move budget. Where did you over- or under-spend? Update the next-move template.
☐ Update the asset register with the new locations of every tracked item.
☐ Verify and act on utilization data for the new office. The early days show whether the floor plan, desk count, and room mix are working. DeskFlex analytics makes the early data visible.
☐ Document lessons learned for the next move. Most growing companies move every 3 to 7 years.
Office Move Checklist by Category
Some items span the entire timeline rather than fitting neatly into one phase. Below is a category-by-category checklist for cross-cutting topics.
Budget and Finance
☐ Approved move budget with line items
☐ CFO sign-off on every major expense
☐ Contingency budget (10-15% of total)
☐ Insurance coverage for the move itself
☐ Updated business insurance for the new location
☐ Workers compensation update
☐ Vendor contracts with payment schedules
☐ Final reconciliation 30 days after move
Real Estate and Lease
☐ Current lease review (end date, restoration, holdover)
☐ New lease signed and reviewed by counsel
☐ Build-out allowance and TI work scheduled
☐ Free-rent period documented
☐ Restoration plan for the old space
☐ Security deposit recovery from old space
☐ Permits and certificates of occupancy in place
Technology and IT
☐ New office network design and cabling
☐ Internet circuit provisioned and active
☐ Phone system migration and number porting
☐ AV and meeting room equipment installed
☐ Server and infrastructure migration plan
☐ End-user device transition
☐ Security and access control configured
☐ Desk booking, room scheduling, and visitor management deployed
☐ Asset tagging and tracking through the move
Furniture and Equipment
☐ Inventory of every item in the current office
☐ Decision per item: move, sell, donate, dispose

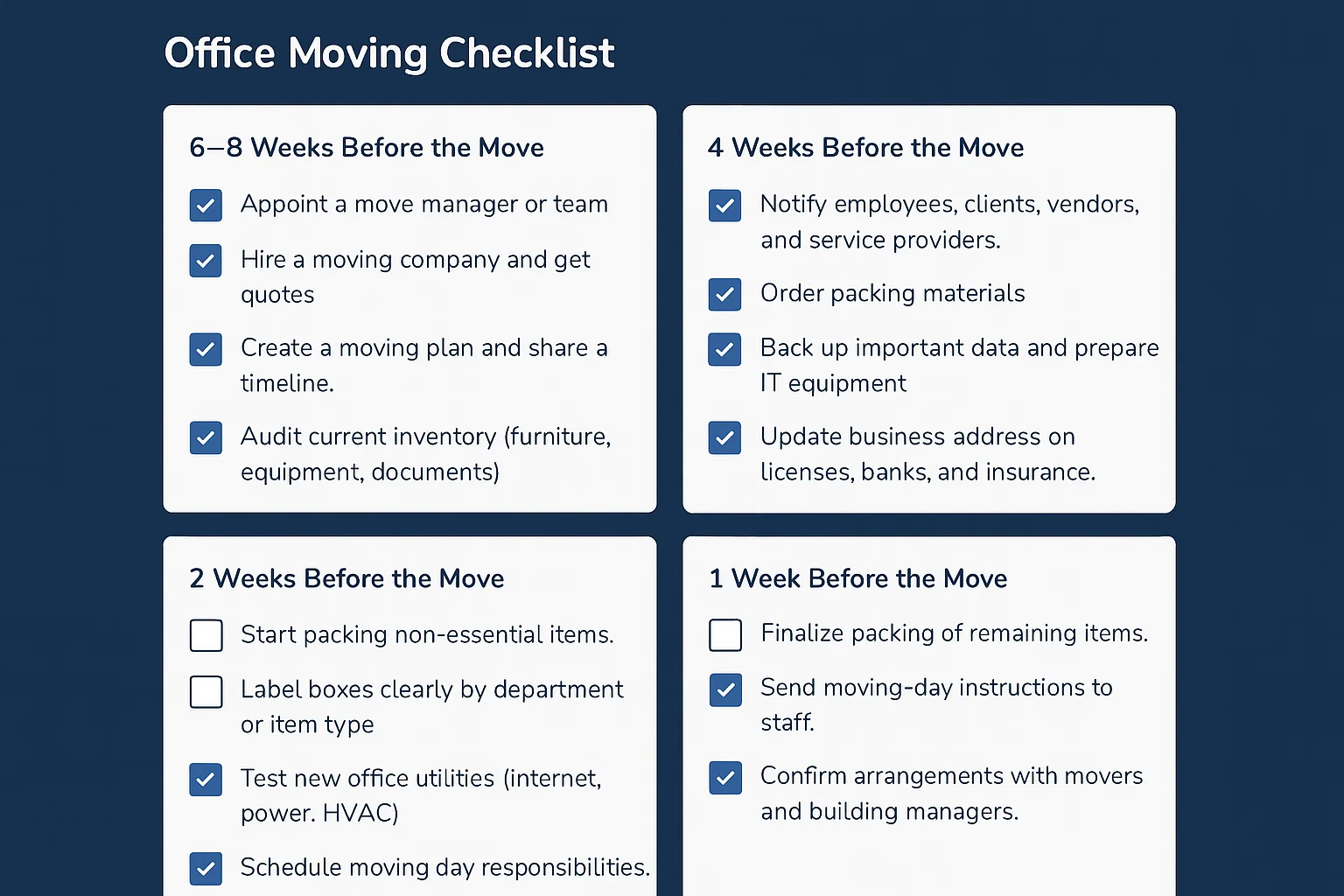

☐ New furniture ordered (8-16 week lead times common)
☐ Delivery and installation scheduled to align with move
☐ Old furniture disposal or donation arranged
☐ Specialty equipment plan (labs, manufacturing, healthcare)
HR, People, and Culture
☐ Initial all-hands announcement
☐ Detailed timeline communication
☐ FAQ document distributed
☐ Commute and parking communications
☐ Accommodations for affected employees
☐ Move-day team roles defined
☐ First-week tours and orientation
☐ Post-move feedback survey
Vendors and External Parties
☐ Commercial moving company contracted
☐ IT vendors engaged (ISP, phones, AV, security, cabling)
☐ Furniture vendor orders placed
☐ Construction contractor schedule confirmed
☐ Decommissioning vendors lined up
☐ Cleaning and waste vendors scheduled
Legal, Regulatory, and Compliance
☐ Lease and permits reviewed by counsel
☐ Industry-specific regulators notified
☐ Business address updated with every government agency
☐ Updated W-9 and tax documentation
☐ Contracts with updated address clauses where required
☐ Sensitive document destruction plan
Communications and External Presence
☐ Internal announcement to employees
☐ External announcement to clients and suppliers
☐ Website, Google Business Profile, Yelp update
☐ Social media profile updates
☐ Business cards, signage, marketing collateral updates
☐ Email signature and template updates
☐ Invoice and contract template updates
Common Office Move Mistakes to Avoid
After thousands of office moves across hundreds of clients, the same mistakes appear over and over. These are the nine most expensive ones, and they are all preventable.
1. Starting too late
The single most common mistake. Office moves work backwards from commercial mover availability, furniture lead times, and internet provisioning. All three commonly run 8 to 16 weeks. Starting six weeks out means making bad decisions under time pressure. Start at least six months out for moves under 50 people, twelve months for anything larger.
2. Underestimating the budget
Office moves consistently come in over budget. The most common reason: forgotten line items. Restoration of the old space, IT cabling at the new space, signage, security and access cards, furniture not yet decided on, contractor change orders, and the catered launch party. Build a 10-15% contingency from day one and treat it as untouchable until the final 30 days.
3. Choosing the wrong moving company
Residential movers do not handle commercial office moves well. Look specifically for commercial movers with references in your industry, insurance that covers high-value equipment, experience with after-hours and weekend moves, and the equipment for heavy or specialized items (servers, machinery, art).
4. Skipping the inventory
If you do not have a tagged inventory before the move, you will lose 5 to 10 percent of asset value in the move and never know what is missing until you need it. Tag everything before the move starts. The move is also the natural moment to set up workplace asset management if you do not already have it.
5. Underestimating IT lead times
Internet circuits, phone number porting, structured cabling, security and access control, and AV installation all have lead times measured in months, not weeks. Lock these in at least 90 days out. The cost of moving on schedule but with no internet for two weeks is enormous.
6. Insufficient employee communication
Employees who feel surprised by an office move are more likely to leave. Communicate early, communicate often, share the floor plan, name the trade-offs honestly, and provide a clear escalation path for concerns. Anonymous feedback channels matter.
7. Treating IT as the move team’s job
IT migration is its own project with its own timeline, dependencies, and risks. Treat it as such with a dedicated IT lead, separate planning meetings, and separate go-live milestones. The IT lead reports to the move project lead but runs IT autonomously.
8. Not planning the old office decommissioning
The lease restoration obligations, final cleaning, lock changes, key returns, and security deposit recovery do not happen automatically. Most companies leave money on the table at the old office while focusing on the new one. Plan decommissioning as carefully as you plan move-in.
9. Skipping the post-move review
Most companies finish the move and never look back. The lessons learned from a move are valuable for future moves (most growing companies move every 3 to 7 years), for vendor selection (which vendors were good, which were not), and for the workplace strategy as a whole (did we get the floor plan right, did we under- or over-buy on space). Run the review 30 days after move day while memory is fresh.
How Much Does an Office Move Cost?
Costs vary by city, size, complexity, and industry, but the typical commercial office move falls in these ranges per employee:
| Move Type | Cost per Employee | Notes |
|---|---|---|
| Local move, basic furniture, under 50 people | $1,000 to $2,500 | Limited build-out, reused furniture |
| Local move, mid-sized, partial fit-out | $2,500 to $5,000 | New furniture, some IT upgrades |
| Local move, premium, full fit-out | $5,000 to $7,000 | New design, all-new furniture, full IT |
| Long-distance move | Add 30–50% to local equivalent | Travel, time, additional logistics |
| Specialty (lab, healthcare, manufacturing) | Add 50–100%+ | Specialized handling, validation, compliance |
For a 100-person office doing a mid-range local move with a partial fit-out, the total commonly lands between $250,000 and $500,000. For a 500-person move with a premium fit-out, $2 to $4 million is typical.
The biggest line items are usually: –
- Build-out and construction: 30-50% of total
- New furniture and equipment: 15-25%
- IT and AV (cabling, network, AV systems, security): 10-20%
- Moving company and logistics: 5-10%
- Real-estate fees (broker, legal, deposits): 5-10%
- Contingency: 10-15% (build this in from day one)
For more detail, our forthcoming office move budget guide goes into line-item breakdowns by company size.
How DeskFlex Makes the New Office Work from Day One
Office moves are the perfect moment to set up a workplace management platform in the new space. You are already redesigning floor plans, reconfiguring rooms, training people on new processes, and starting fresh on workplace norms. The marginal effort of deploying desk booking, room scheduling, visitor management, and space analytics during the move is much smaller than retrofitting them later.
DeskFlex helps with five specific parts of an office move:
1. Designing the new floor plan
3D floor maps let your move team and stakeholders visualize the new office before move day, model desk-to-employee ratios against expected attendance, and identify problems on screen before they appear in steel and drywall.
2. Setting up desk booking from day one
For hybrid offices, desk booking is one of the fastest wins from a move. Employees arrive on day one and find a working booking system rather than a chaotic free-for-all. The move is the easiest moment to roll this out because no one has a “my desk” yet.
3. Configuring room scheduling and meeting-room hardware
The new office’s meeting rooms need scheduling, room displays, and integration with Outlook or Google Calendar. Room scheduling handles this end to end including abandoned meeting protection for unused bookings.
4. Visitor management for the new lobby
The first impression for visitors in the new office is the lobby. DeskFlex’s visitor management gives you QR check-in, host notifications, badge printing, and a clean experience from day one.
5. Asset tracking through the move and into the new office
Asset management tracks every piece of office equipment through the move and into its new home, with mobile QR scanning for moves and quarterly cycle counts. Office moves are the single biggest cause of asset attrition, and this is the prevention.
If you are planning an office move, book a 30-minute demo and we will walk through how DeskFlex fits into the move timeline.
Conclusion
A well-run office move starts six to twelve months in advance, follows a detailed phase-by-phase checklist, costs between $1,000 and $7,000 per employee, and ends with a settled team in a workspace that fits how they actually work. The difference between a smooth move and a chaotic one is almost entirely down to the checklist. Plan from the timeline above, work the category checklist for cross-cutting items, avoid the nine common mistakes, and run the 30-days-after review.
The office move is also the easiest moment to deploy modern workplace technology. Desk booking, room scheduling, visitor management, and asset tracking are dramatically easier to roll out in a new office where no one has settled into old habits than in an existing office where every change creates friction. DeskFlex deploys all four during the move timeline, so the new office works from day one.
Frequently Asked Questions (FAQs)
How far in advance should I start planning an office move?
For a small office move (under 50 people), start at least six months in advance. For mid-sized moves (50 to 500 people), plan on 9 to 12 months. For large or complex moves (500+ people, multi-site, specialty industries like healthcare or manufacturing), 12 to 18 months is typical. The driving constraints are commercial mover availability (8 to 12 weeks in peak season), furniture lead times (8 to 16 weeks), internet provisioning (30 to 90 days), and construction lead times (3 to 6 months for typical office build-outs).
How much does an office move cost?
The typical commercial office move costs between $1,000 and $7,000 per employee depending on complexity, distance, and how much is being reused or replaced. A local move of 100 people with mid-range fit-out commonly runs $250,000 to $500,000 total. A 500-person move with a premium fit-out is typically $2 to $4 million. The largest line items are usually build-out (30-50% of total), new furniture (15-25%), IT and AV (10-20%), moving and logistics (5-10%), real-estate fees (5-10%), and contingency (10-15%, which you should build in from day one). Specialty moves like labs and healthcare add 50% or more.
What is the most important thing on an office move checklist?
The single most important item is starting early enough. Most office move failures trace back to starting too late, which forces every downstream decision into time pressure and limits vendor choice. The second most important item is a tagged asset inventory before the move begins because 5 to 10 percent of asset value is typically lost during moves without active tracking. The third is a 10 to 15 percent budget contingency, untouchable until the final 30 days, because every move discovers unexpected costs.
How do I write an office move announcement to employees?
A good office move announcement covers six things in plain language:
(1) the reason for the move,
(2) the new location and basic transit information,
(3) the timeline including move date,
(4) what will change for employees including commute, parking, and accommodations,
(5) what will stay the same, and
(6) where to ask questions or raise concerns. Keep it short (under 500 words), name the trade-offs honestly, and follow up with detailed FAQs within a week. The biggest morale risk is information vacuum. When leadership stays quiet, rumors fill the gap.
How do I plan an office move?
Planning an office move follows 10 phases:
(1) 12+ months out, make strategic decisions about the move and engage a broker;
(2) 6 to 12 months out, select the new office, secure budget approval, and start design;
(3) 3 to 6 months out, select vendors, form the move team, and announce internally;
(4) 1 to 3 months out, finalize floor plans, plan IT migration, and detail employee communications;
(5) 2 to 4 weeks out, send address-change communications and start packing;
(6) 1 week out, finalize logistics and brief everyone;
(7) moving day, execute and oversee;
(8) day after, handle initial setup;
(9) first week, settle in and gather feedback;
(10) 30 days after, decommission the old office and run the lessons-learned review. The checklist above details every action item per phase.
What should I do the day before an office move?
The day before move day, complete these tasks: confirm move-day logistics with every vendor in writing, brief the move-day team on roles and responsibilities, walk both spaces with the moving company one final time, prepare a moving-day essentials box (tools, cables, first aid, snacks, water, basic stationery, toilet paper), back up all critical IT systems, collect all spare keys and badges from staff, set up move-day signage at both locations, and confirm the new office has working internet and phones for day one. Keep the evening for rest. Move day is long.
How long does an office move actually take?
The move itself (loading, transporting, unloading) takes one to three days for typical commercial office moves under 200 people. The total project takes six to twelve months when run well. The productivity dip from announcement to full settling in is typically 10 to 20 percent for two to four weeks before and after move day. Companies that plan well minimize the dip; companies that wing it can lose six to eight weeks of productivity.
How do I move IT equipment safely?
Moving IT equipment safely requires four things:
(1) a complete inventory tagged with destination locations before any equipment is moved;
(2) a backup of every critical system before move day;
(3) a commercial mover with experience handling IT equipment, not residential movers;
(4) a planned IT downtime window with all stakeholders informed. For servers and networking gear, schedule the move overnight or over a weekend so the downtime is invisible to the business. For end-user devices, have employees back up locally and label their own equipment with a destination code. Test core systems within hours of arrival at the new office while vendors are still on site.
Should we move all our furniture or buy new?
The answer depends on the age and condition of your current furniture, the design vision for the new office, and your budget. As a rule of thumb: furniture under 5 years old in good condition is usually worth moving; furniture over 10 years old is usually not. Office moves are also the natural moment to address ergonomic issues, standardize equipment, and align furniture with new ways of working (hybrid neighborhoods, hot-desking, focus rooms). Most companies end up with a mix: keep some, replace some, donate the rest.
What do you do with old office furniture and equipment?
The four main options are:
(1) move it to the new office,
(2) donate to charity (typically generates a tax deduction and clears the space at low cost),
(3) sell to an office liquidator or via auction (recovers some value but takes time), and
(4) dispose responsibly through a commercial removal service (costs money but is fast and certain). For confidential paper documents and decommissioned IT, use a certified destruction service that provides chain-of-custody and a destruction certificate. Many commercial movers offer liquidation and disposal as a packaged service.
How do I handle remote employees during an office move?
Remote employees are often overlooked in office moves but they should be communicated to at the same time as in-office staff.
They need:
(1) the same announcement and FAQ as everyone else,
(2) updated business address information for tax and HR purposes,
(3) updated company-website and signature information,
(4) any policy changes (for example, if the office move comes with a hybrid policy change),
(5) the new shipping address for any equipment, and
(6) clarity on whether they are expected to attend any move-related events. The move is a high-value moment to also re-confirm remote-work agreements, equipment ownership, and home-office stipends.
What is the difference between an office move and an office relocation?
In practice, the terms are used interchangeably. Both refer to moving a business operation from one commercial location to another. “Office move” tends to be used for shorter-distance moves and “office relocation” for longer-distance or more strategic moves, but there is no formal definition. Both follow the same general framework: plan, prepare, pack, move, settle.
How do I know if my company is ready for an office move?
The clearest signals that a move is needed are: lease expiry approaching with no good renewal option, headcount that has outgrown the current space, hybrid-work attendance that makes the current space oversized, location issues affecting recruiting or retention, building condition or landlord issues, or a strategic shift requiring a different kind of space. The clearest signals that a move is risky are: insufficient lead time, unclear executive sponsorship, no defined budget, and no project lead identified. If you are unsure, run a workplace strategy assessment first to clarify needs before committing.
Can DeskFlex help with planning an office move?
DeskFlex is not a moving company, but the platform helps with several parts of a move: 3D floor maps for designing the new office layout, desk booking and room scheduling for setting up the new office from day one, visitor management for the new lobby, asset management to track every piece of office equipment through the move, and space analytics to verify that the new floor plan is actually working in the first 30 days. The office move is the easiest moment to deploy these because no one has settled into old habits yet. Book a demo to walk through how DeskFlex fits your move timeline.





































Support
Demo
Blog
Newsroom
